Coordinating Stair Openings in CFS Floors
Coordinate stair-opening geometry, framed edges, landing supports, and clearance requirements before releasing CFS floor fabrication.

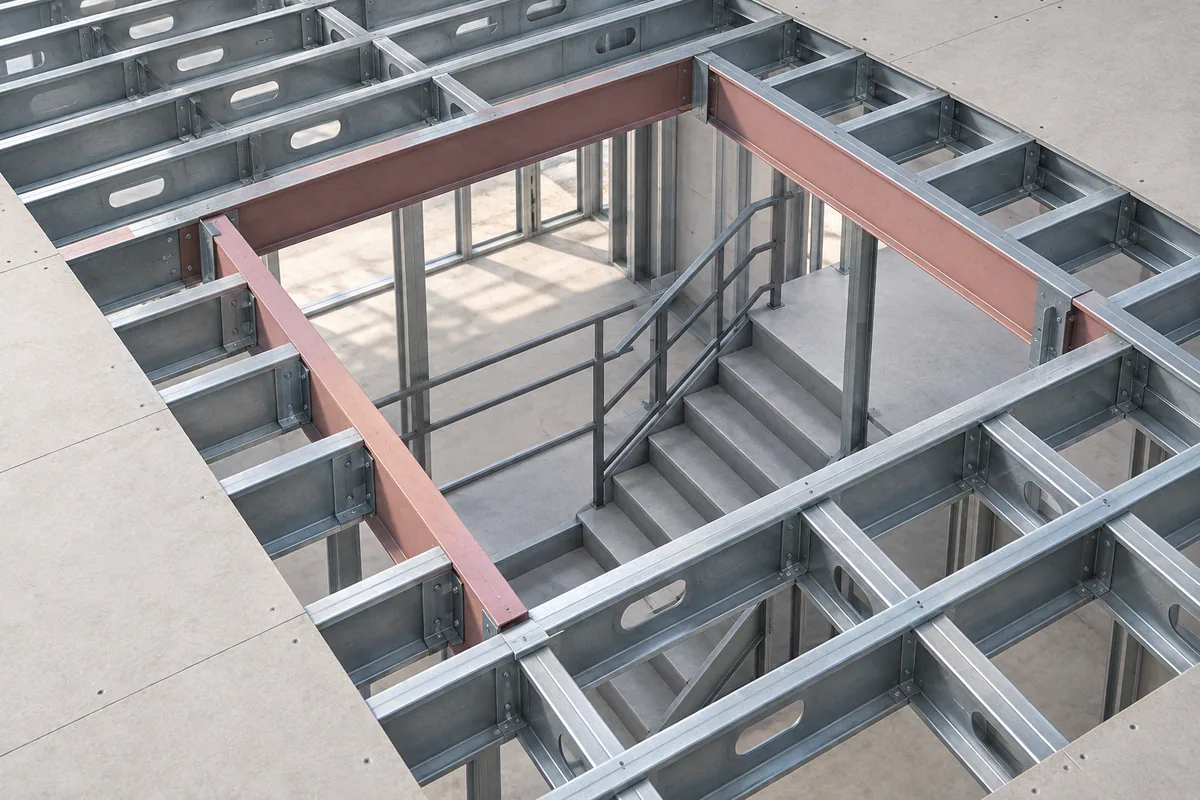

The condition to resolve
A stair opening is not just a rectangle removed from the floor plan. The stair package can introduce landing supports, edge attachments, guard requirements, and finished clearances. Those requirements need to fit the reviewed opening framing. Small architectural changes can affect adjacent joist marks and connections even when the stair occupies the same general area.
Coordinate before releasing the work
Overlay approved stair geometry with the structural opening and floor elevations. Identify who designs and supplies opening-edge members and stair attachments. Review headroom and finish buildup using coordinated sections. Issue changed dimensions to both stair and floor suppliers so neither fabricates from a superseded opening schedule.
How it fits the building system
A cold-formed steel floor is an assembly of joists, supports, restraint, deck or sheathing, finishes, and connections. Review the entire assembly rather than ordering joists from a span alone. Manufacturer data describes specific products and conditions; the project designer must reconcile those conditions with the building's loads, openings, and supporting construction. Product substitutions can change interfaces even when the nominal member depth remains the same.
Prepare a coordinated floor section showing the structure, service zone, ceiling, and finished floor elevation. Locate bearing lines and special openings in plan, then track the details that cannot be seen after enclosure. Before releasing an area for subsequent work, check that temporary construction activities and stored materials follow the approved construction plan. A finished-floor review and an installation-stage review answer different questions.
References: TradeReady steel joists: system data and application limits · TradeReady floor joist blocking · Current technical notes for CFS walls, floors, connections, and inspection
Practical location-based review
Assign an owner, location, and response document to each check. Include affected trades before fabrication or concealment; final dimensions and connections belong in the approved project documents.
- Overlay stair landings and attachments with opening-edge framing.
- Confirm structural opening dimensions and finished clearances separately.
- Coordinate revision release between stair and floor suppliers.
Documents and decisions that must agree
Keep this comparison beside the current drawing. Record discrepancies as specific questions and preserve the response in that area's records.
| Item | Evidence needed | Decision to confirm |
|---|---|---|
| Opening | Coordinated framing plan | Accepted structural dimensions |
| Landing | Stair support submittal | Reaction and attachment interface |
| Clearance | Finished section | Headroom and finish buildup |
Verification and handoff to the next trade
At the opening handoff, verify its measured geometry against the accepted stair package and identify the intended attachment zones. Preserve inspection access to edge framing before installing stair finishes or guards. Record any field discrepancy with the adjacent joist marks and floor elevations, then obtain the relevant response before enlarging the opening. Final acceptance should connect the framed opening, stair support, and finished clearance records to the same revision.
Give the next trade the current detail, the restrictions it must preserve, and open observations. Verify the installed work before concealment and retain an identifiable location in the final record.
Common questions
Can a joist be removed to enlarge the stair opening?
That changes the floor assembly and needs the assigned structural review. Coordinate replacement edge framing and stair interfaces through revised documents.
Is the architect's opening dimension the finished stair clearance?
Not necessarily. Distinguish structural opening, framing, finishes, and stair geometry in coordinated sections before approving fabrication.
Sources & further reading
Use the current documentation for the exact product and project. Source links do not imply a partnership or endorsement.
- TradeReady steel joists: system data and application limits ClarkDietrich
- TradeReady floor joist blocking ClarkDietrich
- Current technical notes for CFS walls, floors, connections, and inspection Cold-Formed Steel Engineers Institute
Prepared with AI assistance. Linked references require current project-specific review. How these guides are prepared.
Prepare a supply inquiry
- Record the project drawing or detail and the specified product, profile, or system.
- List the complete configuration, physical units, quantities, and cuts per piece.
- Request current manufacturer documents; confirm compatibility, price, and availability before ordering.
- Obtain the responsible professional's review for loads, code requirements, or installation.
